How Much Does Soil Stabilization Cost for Construction Sites?
Last updated: September 10, 2026
Key Takeaways
- Stabilizing the top 6 inches is very different from treating 12 to 18 inches, so consult a geotechnical professional before you price it.
- Mobilize equipment — often 1 day.
- Strip, dry, mix, or compact — 1 to 3 days for smaller sites.
- What compaction target are you pricing: 95% of standard Proctor, modified Proctor, or something else? ASTM D698 and ASTM D1557 set those test methods, but the project spec still governs the target.
Soil stabilization for a construction site usually costs from a few dollars per square yard for light treatment to far more for deep ground improvement. The real figure depends on what sits under the site, how much material needs treatment, and how quickly the crew has to finish. So the question, how much does soil stabilization cost for construction sites, never has one clean answer. In Phoenix, Dallas, Atlanta, or Orlando, I’d expect the price to shift mainly with soil type, moisture, access, and whether the job calls for lime, cement, geogrid support, or mechanical compaction before concrete or paving can begin.
What soil stabilization usually costs on a construction site

Usually, it costs less than rebuilding a failing subgrade later. Still, the quote can swing hard because the work may be as simple as drying and compacting a pad, or as involved as mixing binders into several inches of weak clay. For a typical site in a growing metro area like Austin, Tampa, Charlotte, or Houston, a contractor may price by the square yard, square foot, ton of binder, or linear foot, depending on whether the job is under a building pad, road base, utility trench, or parking lot.
So, if you are pricing how much does soil stabilization cost for construction sites, ask for the unit basis up front. Cleaner comparison. Less hand-waving.
Here is the kind of pricing structure I would expect a buyer to ask for:
| Stabilization method | Typical use | Common price structure |
|---|---|---|
| Proofrolling and recompaction | Reworking disturbed subgrade | Lower-cost mobilization plus labor and equipment |
| Moisture conditioning | Drying or wetting soil to reach compaction target | Added hourly equipment and trucking time |
| Lime stabilization | Expansive clay and plastic soils | Often priced by ton of lime plus mixing and compaction |
| Cement stabilization | Improved stiffness for subgrade or base | Often priced by ton of cement plus spreading and mixing |

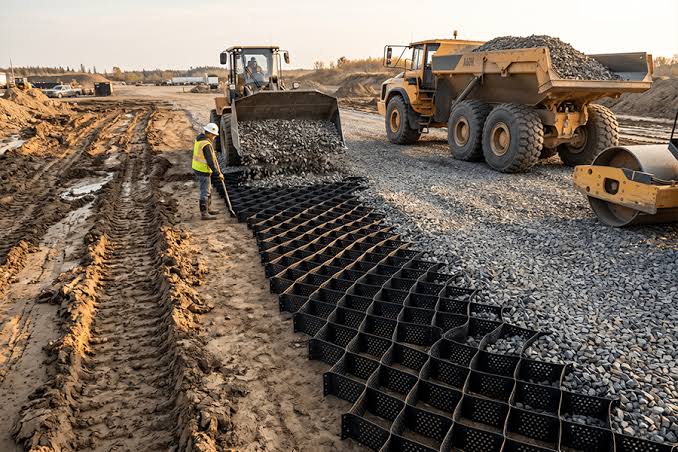

| Geotextile or geogrid reinforcement | Weak soils, separation, load distribution | Material plus installation, often by square yard |
| Deep soil mixing / specialty ground improvement | Very poor soils, high loads, or tight settlement limits | Highest-cost option, usually quoted as a custom scope |
The cheapest quote is not always the real bargain. A low number that skips moisture control, proofing, or lab testing can leave you with a soft subgrade, and then the slab settles or the paving fails. Ugly fix. If you are in Clay County, Jacksonville, or the flood-prone edges of Charleston, South Carolina, I’d be suspicious of any bid that ignores groundwater, drainage, or the cost of hauling unsuitable soil. For more on drainage and subgrade basics, see the FHWA guidance on pavement subgrades and TxDOT materials and earthwork resources.
For a practical buying decision, I’d treat soil stabilization as a site-specific civil work item, not a commodity, and I’d recommend that you consult a geotechnical engineer before locking in a scope. A small warehouse pad in Fort Worth can be straightforward; a site with fill, organics, or active clay in San Antonio can turn into a much larger stabilization job after testing.
What changes the price in Dallas, Houston, and other Texas sites?
Soil stabilization costs more in Texas when the site has expansive clay, variable fill, or poor drainage. Those conditions are common enough around Dallas–Fort Worth, Houston, Austin, and San Antonio that I would never assume a flat rate. In North Texas, the headache is often high-plasticity clay that shrinks and swells with moisture. Around Houston, the issue is usually soft, wet subgrade and a water table or drainage pattern that complicates drying, compaction, and haul-off. Texas A&M AgriLife and the USDA NRCS Web Soil Survey are useful starting points for understanding local soil conditions.
The biggest cost drivers are usually these:
- Soil condition at the time of work. Wet clay takes longer to treat than dry sandy soil, and a geotechnical consultant should confirm the field condition before pricing.
- Depth of treatment. Stabilizing the top 6 inches is very different from treating 12 to 18 inches, so a deeper section almost always changes the cost.
- Binder type. Lime, cement, fly ash, and blended products do not price the same.
- Testing requirements. Proctor curves, moisture-density targets, and field density tests can add lab and inspection costs.
- Access and haul distance. Tight urban sites in downtown Austin or central Houston cost more to mobilize than open land outside Conroe, Hutto, or Denton.
- Weather delay. A wet week can stall earthwork and keep crews waiting.
- Contamination or organics. If the site has unsuitable fill, root matter, or debris, stabilization alone may not solve it.
I’d also watch drainage and subgrade prep before accepting any bid. A contractor who can show a clear plan for moisture conditioning, compaction, and field verification is usually a safer bet than one offering a low lump sum with vague language like “as needed.”
For nearby service areas, the same logic usually applies in Plano, Irving, Frisco, Garland, Pasadena, Sugar Land, Round Rock, Georgetown, and New Braunfels. The soil changes, but the pricing drivers do not: moisture, access, depth, and testing control the bill. If you are comparing bids, keep the question framed as how much does soil stabilization cost for construction sites in your exact city and soil profile, not in the region broadly.
How much does soil stabilization cost by method?

The method matters more than the label, and the wrong choice can get expensive even when the unit price looks low. A simple recompaction job on a clean subgrade may stay near the low end of the market, while lime or cement treatment adds material cost, mixer time, and quality control. A deep system for a weak industrial site can move into a completely different budget class. Check a USACE or FHWA design reference when the project has tighter performance requirements.
A buyer should think in terms of scope:
- Recompaction and grading: best for disturbed but otherwise suitable soil. Usually the least expensive option.
- Moisture control and aeration: useful when soil is too wet for compaction, especially after rain in Orlando or Nashville.
- Lime stabilization: often chosen for plastic clays common in North Texas and parts of the Southeast.
- Cement stabilization: often chosen where a stiffer, faster-set base is needed for roads, yards, or pads.
- Geosynthetics: useful when you need separation or reinforcement without overexcavation.
- Overexcavation and replacement: not technically stabilization in every case, but sometimes the smartest fix when the top layer is too weak or contaminated.
- Deep mixing or specialty ground improvement: for serious settlement risk, wet ground, or heavy loading.
If a contractor quotes cement treatment for a site that only needs regrading and proofrolling, the price can be higher than necessary. If the contractor quotes only grading for a site that actually has expansive clay or organics, the job can fail later. That trade-off is why I’d ask for a written recommendation tied to the soil report, not a generic “per yard” number.
How long does soil stabilization take before construction can start?
Soil stabilization usually takes 1 to 5 days for small-to-mid-size pads and longer for larger or deeper projects, but curing time can stretch the schedule beyond the day the crews leave. The actual working time depends on acreage, binder type, weather, and how much testing the project requires before the next phase can start. For owners asking how much does soil stabilization cost for construction sites, time is part of the bill because extra days on site mean more labor, equipment, and delay risk.
A simple sequence often looks like this:
- Review soils report and scope — same day to a few days.
- Mobilize equipment — often 1 day.
- Strip, dry, mix, or compact — 1 to 3 days for smaller sites.
- Field density and moisture testing — same day or next day.
- Curing or hold time — can be several hours to several days, especially with cement or blended binders.
- Re-test and release for paving or slab work — after the required standards are met.
The schedule matters because a fast start is not always a real win. In Atlanta or Birmingham, a rainy stretch can turn a one-day job into a three-day delay if the site keeps getting too wet to compact. In Phoenix, the heat can speed drying, but it can also make surface moisture disappear while the subgrade below is still out of spec. Looks ready. Fails anyway. For schedule planning, the FHWA and ASTM references are better than rule-of-thumb guesses.
If your project has a hard deadline, I’d ask the contractor to state the testing hold points and the weather assumptions in writing. That matters on commercial pads, tilt-wall work, and road jobs where one missed test can hold up the next trade.
How do I vet a soil stabilization contractor in my area?
You vet a soil stabilization contractor by asking for the soil report-based scope, the compaction standard, the testing plan, and proof of licensing or registration where required, not by chasing the lowest number. In Texas, for example, many earthwork and grading contractors operate under local business and permitting rules rather than one single statewide “soil stabilization license,” so the real check is whether they can perform the work legally in your city and coordinate with the engineer and inspector. If you are comparing how much does soil stabilization cost for construction sites, a bid that cannot explain those basics is not ready to price the job.
I’d ask these questions before I signed anything:
- What soil report did you use?
- What compaction target are you pricing: 95% of standard Proctor, modified Proctor, or something else?
- What depth are you stabilizing?
- What binder or reinforcement are you proposing, and why?
- Who pays for failed tests and rework?
- How do you handle wet weather, pumping, or unsuitable material?
- Is haul-off included if the soil must be removed?
- What permit or inspection steps apply in Houston, Dallas, Austin, or San Antonio?
That last point matters because local rules can add time and cost. A commercial site may need grading approval, erosion control, or a civil inspection before stabilization work proceeds, especially if stormwater or drainage is affected. If the contractor shrugs off permits, I’d treat that as a warning sign.
I’d also avoid anyone who gives a quote with no mention of standards such as ASTM D698, ASTM D1557, or the project’s compaction requirement. Those references tell you the bid is tied to a measurable result, not guesswork. If your project is in a suburb like Katy, Cypress, McKinney, Addison, Carrollton, or Pflugerville, the same rule applies: a serious contractor can explain the testing path in plain English. For a deeper check, the USACE earthwork standards and TxDOT compaction guidance are useful benchmarks.
Red flags: quotes that should worry you
A soil stabilization quote should worry you if it is vague, unusually fast, or missing testing, because those gaps usually show up later as change orders or failed compaction. If one bid is dramatically below the others in Fort Worth, Orlando, or Charlotte, I would assume something was left out unless the scope is clearly different. That is especially true on commercial jobs where inspection and acceptance are tied to specific tests.
Watch for these red flags:
- No soils report mention. That usually means the contractor did not price against actual conditions.
- No unit breakdown. A lump sum with no depth, acreage, or binder quantity is hard to compare.
- No testing allowance. If field density testing is missing, the price may not reflect real acceptance.
- “As needed” fill or stabilization. That phrase can hide major unknowns.
- No weather contingency. Wet sites can trigger costly standby time.
- No haul-off line item. Unsuitable soil may need to leave the site.
- Promises of same-day completion for a large site. That is usually unrealistic unless the area is very small and the scope is light.
A quote can also be too detailed in the wrong way. If someone prices a stabilization job without asking for the geotechnical report, the compaction spec, or the pad elevation, the number is probably a guess. I’d rather see a contractor admit that the scope is not final than pretend precision where none exists.
This is also where soil stabilization is not the answer. If the site has contaminated soil, major organic matter, or a settlement problem that needs deeper intervention, stabilization alone may not fix it. In that case, overexcavation, removal, or engineered ground improvement may be the correct path, even if it costs more. The EPA, FHWA, and local geotechnical reports are better guides than a one-line bid.
When is the best time of year to do soil stabilization?
The best time of year for soil stabilization is usually the driest, most predictable part of the season, but the real answer depends on your local rainfall and soil type. In Phoenix, the window is often easier to manage because prolonged saturation is less common. In Houston, Orlando, Atlanta, and the Gulf Coast, I’d plan more cautiously around rain, humidity, and slow drying soil. If you are estimating how much does soil stabilization cost for construction sites, seasonality can move the budget through labor time and weather delays.
Season affects cost in a few concrete ways:
- Wet seasons increase drying time and can force rework.
- Hot, dry periods can make some soils easier to condition but can also cause moisture loss too fast.
- Freeze risk matters farther north, where cold weather can slow earthwork and affect compaction.
- Storm seasons can stop work entirely if erosion controls or drainage are not in place.
If your project is in North Texas, late spring and early fall are often easier than a wet winter pattern or a stormy stretch in summer. If you are in South Florida, the question is less about temperature than about rainfall timing and site drainage. For projects in Raleigh, Nashville, or Memphis, shoulder seasons often make scheduling simpler, but I’d still build in weather days.
Honestly, this is the part people underestimate. A site that is ready on Monday can be too wet by Thursday. If the job is urgent, ask about a same-week site review and whether the contractor can sequence testing, drying, and treatment without losing a week to weather.
FAQs about soil stabilization cost for construction sites
Soil stabilization questions usually come down to cost, timing, and whether the work can start fast enough to keep the project moving. Here are the direct answers I would want before I booked the job.
How much does soil stabilization cost for a small construction site?
A small site often costs less than a larger pad because mobilization is spread over fewer square yards, but the per-unit price can still be high if access is tight or the soil is very wet. A tiny lot in downtown Dallas can cost more per square foot than a larger open tract in Hutto.
Can I get a same-day estimate?
Yes, a same-day estimate is sometimes possible for a visible, accessible site, but the final price usually needs a soils report, site walk, or test data.
